Wind MENA Subscribe
Wind turbines among desert shrubs at the foot of a mountain range

Insights

News briefs, analysis and data from the Wind MENA desk, newest first. Open any report to read it in full here.

Photo: Noah Buscher, Unsplash Licence, via Unsplash

AnalysisMorocco

Four years after the grant, the EIB awards a EUR 1.99 million feasibility contract for Morocco's offshore wind

The EIB contract for studies on a planned 1 GW project off Essaouira runs for up to 43 months, while construction is targeted to start in 2029.
1 min read

Four years. That is how long it took to turn an EIB offshore wind grant for Morocco into a consultant contract.

In September 2022 the EIB and Masen, Morocco’s sustainable energy agency, signed a cooperation agreement with a EUR 2 million grant for an offshore wind feasibility study off Essaouira. MEED reported on 3 September that the EIB has now awarded a EUR 1.99 million contract for the feasibility and environmental studies on a planned 1 GW project. Eleven firms bid. Ten were registered in the European Economic Area and one outside it.

Now read the contract terms. It runs for a maximum of 43 months including possible extensions, and construction is targeted to start in 2029. Count 43 months from an award reported in early September 2026 and the window closes in spring 2030. The source does not state the contract start date, so I read this as an open question.

My prediction: the 2029 date moves. The studies can finish early, but I would not plan a supply chain around that. My view is that a 1 GW offshore project that rushes its environmental assessment pays for it later.

It took four years to buy the question.

Which comes first off Essaouira: the study results or the construction date?

BriefUzbekistan

ACWA Power is building 1,500 km of line to carry 1.5 GW of Uzbek wind

A USD 3.06 billion package in Karakalpakstan bundles turbines, batteries and five substations. We read the grid scope as what sets the schedule.
1 min read

ACWA Power said construction has started on three wind plants totalling 1.5 GW in Kungrad district, Karakalpakstan, a USD 3.06 billion programme. The package includes a 300 MW battery system, about 1,500 km of high-voltage transmission line, three new 500 kV switching substations and two upgraded ones.

ACWA guides commissioning in Q1 2027. UzDaily reports that ACWA’s Karakalpakstan projects as a whole are expected to generate about 8.77 billion kWh a year. President Mirziyoyev launched construction on 18 September, according to UzDaily. Together with the 300 MW Nukus 1 and 2 plants, ACWA’s Karakalpakstan wind fleet would reach about 2.3 GW.

Why it matters

Wind at this scale now arrives as a bundle of turbines, batteries and transmission. We read the grid scope as the part that sets the schedule.

What it means for MENA

We read this as Saudi capital exporting a full delivery model. In our view it becomes a yardstick for wind-plus-grid packages across MENA.

AnalysisEgypt

On the Gulf of Suez, the deadliest part of a wind farm may be the line it does not route

A 2007 bird map still sorts Egypt's best wind land. The EBRD plan for a 550 MW plot puts most of the risk on a 47 km overhead line set by the authorities.
1 min read

Six hundred and fifty six square kilometres of state wind concession on the Gulf of Suez. A government-backed study in 2007 marked 60 percent of it as red zone, closed to turbines because of migrating birds.

That map still sorts the new plots. Suez Wind Energy’s southern 550 megawatt plot landed in the orange zone, where further study is required, beside three plants already in the green, inside an Important Bird Area 100 kilometres long. The EBRD rated the project Category A and is financing the 1.06 billion dollar build with up to 200 million dollars. ACWA Power and HAU Energy are among the sponsors.

Then read the biodiversity action plan. Its estimate for that plot, after mitigation, is 34 soaring birds a year, mostly from collisions with the 47 kilometre overhead line rather than the blades. The EBRD page says line routes are determined by the Egyptian authorities and generally follow existing lines.

Our reading

The developer inherits the wire it will be judged on. We think the market prices this backwards. Wind speed and turbine cost get the models, while the deadliest piece of the project may be the one the developer does not route.

The plan has observers on watch twelve hours a day through 28 October. When the next Gulf of Suez round opens, who prices the wire?

DataSaudi Arabia

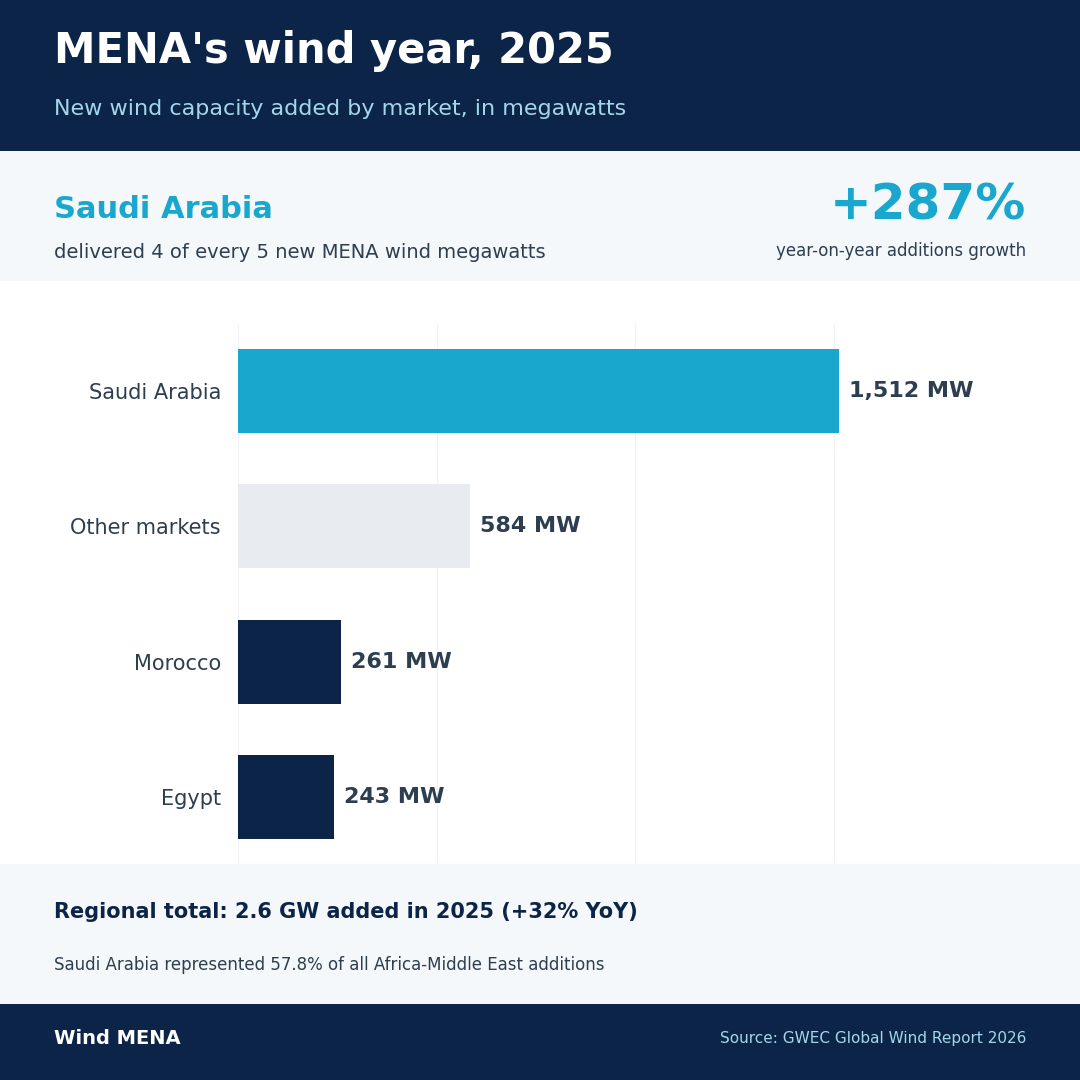

Saudi power awards fell from USD 54.2 billion to USD 3.4 billion. Wind's money is waiting on Round 7

MEED data shows a sharp slowdown in 2026 contract awards. Round 7 bids for 2,200 MW of wind were due in September, but awards may slip into 2027.
1 min read
Bar chart of Saudi power contract awards by year: USD 26.1bn in 2023, USD 54.2bn in 2024, USD 27.5bn in 2025 and USD 3.38bn in 2026 to early September, with wind figures alongside.

Saudi Arabia awarded USD 54.2 billion of power contracts in 2024. By early September 2026, the year’s total stood at USD 3.38 billion.

MEED’s Mark Dowdall puts 2023 at USD 26.1 billion and 2025 at USD 27.5 billion. Wind took USD 4.4 billion of the 2025 awards, and USD 2.2 billion of wind work is still at bid evaluation or main-contract tender.

Round 7 wind bids were due in September: 1,300 MW at Bilgah and 900 MW at Shagra, 2,200 MW together. MEED says contracts from Round 7 may now fall into 2027 rather than materially lifting this year’s total.

Two cautions. These are all-power figures, with wind one slice of them. And MEED links the slowdown partly to a shift toward battery storage and transmission, alongside Round 7 procurement delays.

Our reading

The wind money is at bid stage, with no awards yet. A bid is a promise. An award is a purchase order, and the supply chain only hears the second one.

AnalysisAlgeria

Sonelgaz tenders 200 MW of wind in Laghouat and Djelfa, with bids due 25 November

Algeria's only operational wind farm on record is 10 MW near Adrar. The tender lets foreign firms bid alone, requires Algerian firms to partner with a foreign one and includes grid connection.
1 min read

Algeria generates more than 99 percent of its electricity from natural gas, and its entire wind fleet, on IRENA statistics cited by Ecofin Agency, is one 10 MW farm near Adrar. On 30 September Sonelgaz asked the world to build two more, 100 MW each, in Laghouat and Djelfa.

The reported terms say more than the megawatts do. Bids close on 25 November, eight weeks after launch. Foreign firms can bid alone or in consortium. Algerian firms must partner with a foreign one. The scope runs from study and engineering through civil works, supply, assembly and commissioning, with grid connection included.

Two things stand out. First, 200 MW is a third of the 601 MW of renewables Algeria had installed at the end of 2025, per IRENA figures cited by Ecofin Agency. One tender moves the national total. Second, the coverage I found mentions no power purchase agreement, which suggests a build contract rather than a developer-financed IPP. That is my reading, not a confirmed structure.

My prediction: the partnership rule will decide this field before the turbine price does. With eight weeks on the clock, bidders who already have an Algerian partner start ahead, and everyone else negotiates while they price.

In Algeria, the hardest page of the bid may be the partnership agreement.

Will 25 November draw a real field, or only the consortia that formed before the notice landed?

BriefEgypt

Scatec starts 900 MW Shadwan on a bridge loan, ahead of its project debt

Construction began on 1 October with USD 50 million of Arab Energy Fund bridge financing. Non-recourse debt is expected to close by the end of 2026.
1 min read

Scatec has started building 900 MW of Egyptian wind on a USD 50 million bridge loan, before its long-term project debt has closed.

Construction of the Shadwan onshore wind project began on 1 October, with EDF power solutions targeting a 29 percent equity stake. Capex is USD 716 million and output is about 4 TWh a year. The Arab Energy Fund is providing USD 150 million of three-year equity bridge loans, USD 50 million for Shadwan and USD 100 million for Scatec’s Energy Valley solar and storage project. Non-recourse debt from development finance institutions is expected to reach financial close by the end of 2026, with first-phase commercial operation targeted for the end of 2027.

Why it matters

A bridge loan lets a developer start physical work while lenders finish their own process. For a 900 MW project, we think that can pull a start date forward by months.

What it means for MENA

Scatec has signed mandate letters with a consortium of development finance institutions, and construction now starts ahead of that debt. We read that as Scatec carrying the timing risk until close, which the company guides for year-end. The test is whether the debt lands on schedule and first power follows by end-2027.

BriefOman

Oman books the world wind conference for December 2027, with two wind farms due first

The first World Wind Energy Conference in the Gulf gives Dhofar II and Jaalan Bani Bu Ali a public deadline.
1 min read

Oman will host the 23rd World Wind Energy Conference (WWEC2027) in December 2027, which Oman Observer reports as the first edition in the Gulf. The World Wind Energy Association board approved the decision, and the announcement came at WindEnergy Hamburg 2026. Nama Power and Water Procurement and WWEA will co-organise, supported by Oman’s Ministry of Energy and Minerals. Nama PWP CEO Ahmed bin Salim al Abri pointed to Dhofar and Al Wusta Governorates as potential centres for utility-scale wind.

Why it matters

WWEA counts more than 600 members across about 100 countries, and its flagship event has now picked a Gulf host for the first time. Developers and financiers will get to size up the market against what has actually been built.

What it means for MENA

The 125 MW Dhofar II Wind IPP (targeting Q3 2027) and the 120 MW Jaalan Bani Bu Ali Wind IPP (2027 startup) will shape what visitors see. If both land on time, Oman arrives with 245 MW of new wind and a pitch for Duqm, Mahout and Sadah. If either slips, the pitch gets harder. A conference date is a deadline with a guest list, and we will be watching the construction calendars.

BriefUAE

Masdar and Taaleri open the 154 MW Čibuk 2 wind farm, a winner of Serbia's first wind auction

Čibuk 2 stands beside the 158 MW Čibuk 1 in southern Banat. Balkan Green Energy News reports the 312 MW complex as the largest in the Western Balkans.
1 min read

Serbia ran its first wind auction. One of the winners is now sending power to the grid.

Masdar and Taaleri Energia marked the formal start of operation of the 154 MW Čibuk 2 wind farm at a ceremony in Belgrade. The plant stands between the villages of Bavanište and Mramorak in the municipality of Kovin, in southern Banat, beside the 158 MW Čibuk 1 that the same two partners commissioned in 2019. Čibuk 2 secured a market premium at Serbia’s first wind power auction, and its project company signed a power purchase agreement plus balancing and market-premium contracts with state utility Elektroprivreda Srbije. UniCredit and Erste provided the project financing. Nordex supplied the equipment. Balkan Green Energy News reports the combined 312 MW complex as the largest in the Western Balkans, carrying more than EUR 500 million of foreign direct investment and generating the equivalent of the annual needs of an estimated 178,800 households.

Why it matters

An auction result is a price, and a price is only worth what someone builds against it. Čibuk 2 ran the full circuit in a country that had never held a wind auction before. Bid, market premium, PPA, financial close two years ago, turbines turning now. Serbia’s Minister of Mining and Energy, Dubravka Đedović Handanović, said the two Čibuk plants currently account for around 25 percent of the country’s combined wind and solar capacity.

What it means for MENA

Masdar and Taaleri won Čibuk 2 at Serbia’s opening wind auction and carried it to operation. When Saudi Arabia’s NREP and Egypt’s next tranche score these same names, that is the record that should carry weight. A developer who has converted a first national auction into running megawatts has met risks a buyer of finished assets never has.

BriefOman

O-Green installs a 9.6 MW wind turbine at Duqm to power Oman's turbine factory

The turbine near the OQ8 refinery stands on a 115-metre tower. Its power goes to Duqm industries, including the neighbouring Mawarid Turbine manufacturing facility.
1 min read

A wind turbine went up beside an oil refinery in Duqm this month, and its electricity will feed the factory meant to build the next ones.

O-Green says it has installed a 9.6 MW turbine near the OQ8 refinery in Oman, on a 115-metre tower with blades close to 100 metres long. Arab News reports it as the largest onshore unit of its kind outside China. The power goes to industries at Duqm, including the neighbouring Mawarid Turbine manufacturing facility. That plant traces to usufruct agreements signed in January between OPAZ, Oman’s special economic zones authority, and Mawarid Turbine, covering three plots at Duqm: one for the factory, one for a single turbine, one for five more. Arab News puts planned annual output at 800 to 1,000 MW, with a first phase costing about 70 million Omani rials, roughly 182 million dollars. O-Green says Omani contractors and specialists worked the job “from engineering and site works through construction and the complex transportation and installation of the tower sections and blades.”

Why it matters

A factory’s power normally arrives from the grid at whatever mix the system is running that hour. This one is being wired to its own product. My read is that captive renewable supply turns an industrial site’s power bill from a tariff into an owned asset, and here it happens on an estate that already runs a refinery.

What it means for MENA

Duqm now has something physical on the plot: a 9.6 MW machine standing near the factory site and feeding it. The test from here is whether the rest of the six turbines in that January allocation go up on schedule, and whether the first blades out of the shed are Omani.

BriefUAE

Alcazar closes financing on 131 MW Štip wind farm in North Macedonia on an unnamed corporate PPA

Phase one of Štip reached financial close with about EUR 115 million of senior debt from the EBRD, IFC and Erste Group Bank, and no government offtake support.
1 min read

Alcazar Energy Partners just financed 131 megawatts of wind against a buyer nobody has named.

Alcazar reached financial close on the first phase of the Štip wind farm in North Macedonia, Windtech International reported on 14 September. Twenty-one turbines at 6.25 MW each, 131.25 MW in total, EUR 180 million of investment. Senior debt of roughly EUR 115 million came from the EBRD, the IFC and Erste Group Bank, with Sparkasse Bank AD Skopje supplying a separate local VAT facility. Revenue rests on a long-term offtake agreement with an investment-grade international corporation that the announcement does not name. The plant will run without government offtake support. Phase one is the first of three in a cluster planned at up to 396 MW across Štip, Radoviš and Karbinci.

Why it matters

Two development finance institutions and a commercial bank underwrote senior debt against a corporate offtaker rather than a sovereign-backed tariff. We read this as the structure that financed much of European onshore wind, and Alcazar has now executed it.

What it means for MENA

The wind offtakers we write about here are mostly state entities. Alcazar has now signed the other kind of contract, and its credit team holds a live comparison between a ministry’s covenant and a corporation’s. In our read, what made Štip financeable was a private buyer willing to sign long term. Building a market that produces such buyers is slower work than building the turbines, and it decides who gets to be the counterparty on the next one.

AnalysisMENA

Heavy leading-edge erosion can cut wind output by up to 25%, and MENA builds in Gulf dust

Rolls-Royce runs synthetic desert dust through engines in a £1 billion durability programme. Sandia found blade erosion can cut annual energy production by 5 to 25 percent.
1 min read

In a Rolls-Royce test cell at Sinfin, engineers blow fake Middle Eastern dust through a jet engine on purpose.

The recipe came from geologists and engineers in the DUST group at the University of Manchester, who built a synthetic dust that replicates the fine, talcum-powder-like particles found in desert regions. Standard test dust has the wrong chemistry and would not stress the engine the same way. That work belongs to a one billion pound durability programme aimed at doubling the lifespan of engines such as the Trent XWB-97 by 2028. Modified engines have already returned to service showing a 60 percent increase in time between overhauls.

Aviation folded Middle Eastern dust into a billion-pound durability programme. On the wind side I cannot point to anything comparable.

Sandia National Laboratories measured what erosion does to a blade. Light erosion may cut annual energy production by 5 percent, heavy erosion by as much as 25 percent, and the aerodynamic damage shows up inside the second year of operation.

MENA keeps building wind into desert air.

So I would ask one question earlier than it usually gets asked, and I would point it at the asset rather than the tender: which leading-edge protection system went on these blades, and what erosion curve went into the twenty-year energy forecast? Answer it in the specification and it costs a coating. Answer it in year three and it costs output for the seventeen years still to come.

BriefUAE

Masdar and RWE agree to consider joint bids in German offshore wind auctions, above EUR 3 billion

A separate Masdar MoU with Luxcara covers storage and offshore wind, potentially above EUR 5 billion. Together they could open the way for more than EUR 8 billion of investment.
1 min read

Two agreements announced last week would take Masdar into German offshore wind at the auction stage.

Masdar signed a memorandum of understanding with RWE to consider joint participation in future German offshore wind auctions, at an indicative investment value of more than EUR 3 billion. Reuters puts the auctions in question at Germany’s 2027 round. A separate MoU with Luxcara, a German energy infrastructure asset manager, covers battery storage, offshore wind and potentially other technologies across Germany and wider Europe, with a potential value above EUR 5 billion. Neither document commits either side to a project: one is an agreement to consider, the other to explore. Masdar and RWE already co-invest in the 630 MW London Array and are jointly advancing the 3 GW Dogger Bank South projects off northeast England.

Why it matters

Masdar says it has invested more than USD 13 billion in Europe and built a portfolio above 15.6 GW, and its first German project is the 476 MW Baltic Eagle, developed with Iberdrola and fully operational since 2025. Considering an auction is a different risk class from acquiring a finished asset. You take development, permitting and price risk before a single foundation exists.

What it means for MENA

An investor that has priced seabed risk in a European auction is a different counterparty to one that only buys operating megawatts. When MENA brings its own first offshore rounds to market, Masdar may already have sat on the bidder side of that process. In my view, that capability is worth more to this region than the euro figure attached to the headline.

BriefKazakhstan

Kazakhstan targets Q3 2029 full operation for Masdar's 1 GW Zhambyl wind plant

The Energy Ministry set the date ten weeks after the 29 June groundbreaking. The project pairs 1,000 MW of wind with 300 MW / 600 MWh of storage for about $1.4 billion.
2 min read

Ten weeks after the capsule went into the ground at Zhambyl, Kazakhstan’s Energy Ministry has put a quarter on Masdar’s 1 GW wind plant. Q3 2029.

The date came out of a meeting between Energy Minister Yerlan Akkenzhenov, Masdar Chief Development and Investment Officer Abdullah Zayed and UAE Ambassador to Kazakhstan Mohammed Saeed Mohammed Al Ariki. The project pairs a 1,000 MW wind plant with 300 MW of storage rated at 600 MWh, on total investment of around $1.4 billion, and construction opened with a capsule-laying ceremony in Zhambyl region on 29 June. The AIIB project file for the same asset, published on 3 April and still listed as proposed with the funding amount to be determined, fills in what the ministry readout leaves out. It counts 140 turbines and two 220 kV overhead lines running roughly 300 km to the existing Zhambyl and Kentau substations, and it states that those lines will be transferred to the Government of Kazakhstan after the scheduled commercial operation date.

Why it matters

Three years and one quarter between a groundbreaking and full operation is a schedule built around more than turbine erection. The AIIB file names the rest of it. Three hundred kilometres of line into two substations. A single-offtaker PPA with the state settlement centre, priced in dollars and paid in tenge at the rate on the day. A Category A environmental classification with five biodiversity receptors rated Critical Habitat and turbines that shut down on demand when priority bird species are flying.

What it means for MENA

Gulf sponsors keep exporting equity, and in our read the terms they accept abroad tend to become the terms they argue for at home. A developer willing to build 300 km of transmission and hand it to a government has priced that somewhere, and we have not seen it in a headline tariff. Who builds the wire, who owns it after commercial operation, and who carries it until first power is, in our view, a line item MENA procurement rarely publishes and every serious bidder models.

BriefMorocco

EIB appoints OWC-led consortium for feasibility study on Morocco's first offshore wind farm

The two-year study, endorsed by MASEN, targets the Atlantic coast near Essaouira and covers site selection, a met campaign, ports, grid integration and permitting.
2 min read

Morocco has picked the coast, the gigawatt figure and the construction year for its first offshore wind farm, and last week the European Investment Bank appointed the consortium that will work out whether the thing can actually be built.

The EIB picked the consultancy OWC to lead a full feasibility study for the project, which MASEN has endorsed and which targets the Atlantic coast near Essaouira. Joining OWC are PHENIXA and SOFECO, both part of Ginger Group, alongside Gaïa Terre Bleue and NOVEC, with ABL covering marine work, ports and harbours. EIB is funding the two-year study through the Facility for Euro-Mediterranean Investment and Partnership Trust Fund. The scope covers site selection, a meteorological measurement campaign, concept design, ports and logistics, the regulatory framework, grid impact and integration alongside Moroccan grid specialists, and the environmental and social impact assessment. EIB and MASEN signed a cooperation agreement on offshore wind in September 2022 with a EUR 2 million grant, and the technical-assistance tender that followed was cancelled in July 2024 before being relaunched.

Why it matters

Read that scope list again. Site data, port capacity, grid rules, permitting law. We would argue every offshore market needs those four before its first auction can clear, and they take years to produce because they cannot be imported from someone else’s coastline. World Bank Group estimates put Morocco’s technical offshore potential at roughly 200 GW, about 22 GW of it suitable for fixed-bottom and 178 GW for floating. Potential is the cheap part.

What it means for MENA

The regional offshore conversation trades in gigawatt figures and end-of-decade dates, and this award is a reminder that four years separated the 2022 EIB-MASEN agreement from the study that starts the real clock. Morocco is buying the unglamorous layer first. A met campaign, a grid study, a legal framework. Plans had advanced to a proposed 1 GW project near Essaouira with construction targeted to start by 2029, per the Union for the Mediterranean as of June 2025. My read: whoever eventually bids that gigawatt will price it off data this consortium is now being paid to collect, which makes the met campaign more worth watching than the tariff talk.

AnalysisEgypt

Alcazar signs terms to buy Egypt's 580 MW Gabal El Zeit wind farms from NREA

The fund would take full operational responsibility for three Red Sea wind farms with turbines averaging eight to ten years of service, selling to EETC under a 25-year PPA.
1 min read

Daniel Calderon’s firm has been putting new renewable capacity into Egypt since 2014. In June it signed terms to buy 580 megawatts that were already turning.

Gabal El Zeit is three operational wind farms on the Red Sea coast, Siemens Gamesa machines averaging eight to ten years of service. Under the terms Alcazar Energy Partners agreed with the New and Renewable Energy Authority, the fund assumes full operational responsibility, extends the asset’s useful life and sells the output to EETC on a 25-year power purchase agreement.

Calderon, Alcazar’s co-founder and managing partner, said in June: “Alcazar Energy is very pleased to contribute, with this project, to Egypt’s privatization efforts supported by the IMF. Together with our 500 MW NIAT Wind project, this investment will also help mobilize close to USD1.0 billion of capital for Egypt’s clean energy sector over the coming months.”

I read the contract as arithmetic first. Machines with eight to ten years behind them, contracted to sell power for twenty-five more, finish at thirty-three to thirty-five years in service. Whoever signs that is underwriting the service crew as much as the wind speed.

What holds my attention is the direction of travel. Alcazar arrived in Egypt as a greenfield investor and built there: four projects at Benban totalling 256 MWp, then a 2 GW onshore wind platform agreed with the government in November 2024. Now it is buying what the state already built. The announcement calls Gabal El Zeit the first strategic renewable power asset offered under Egypt’s privatisation framework.

If this one clears, a state-owned megawatt in this region earns twice. Once from the grid, once from the sale. Which fleet goes on the block after it?

BriefEgypt

PowerChina's Egyptian wind portfolio passes 1.8 GW across three projects

The contractor counts the operating 500 MW Amunet farm plus the 1.1 GW Gulf of Suez and Ras Ghareb projects under construction, with Elalamya on civil works.
1 min read

One contractor has now built or is building more than 1.8 gigawatts of Egyptian wind.

PowerChina said this month that its Egyptian wind portfolio has passed 1.8 GW across three projects: the 500 MW Amunet farm in the Gulf of Suez, now operating, plus the 1.1 GW Gulf of Suez project and the Ras Ghareb project, both still under construction. The company has worked in Egypt since 2012. It also named Elalamya General Contracting, the Egyptian civil works firm it first engaged on Amunet in 2023 and has since taken onto the other two sites. Amunet was poured in temperatures above 40 degrees Celsius, with concrete scheduled outside the hottest hours and turbine lifts timed against wind speed. Last month PowerChina began work on Sungrow’s battery manufacturing plant at Ain Sokhna, on a 50,000 square metre plot.

Why it matters

Turbines are bought in a global auction. Foundations are poured by whoever is already on that coast with the crews and the batching plant. My read is that the second market is far smaller than the first, and when one contractor builds two projects at once, a single schedule slip can land on two balance sheets.

What it means for MENA

We expect Saudi Arabia and Oman to convert larger wind pipelines into construction next. I think their sponsor lists will look nothing alike and their contractor lists may look almost identical. Egypt is where that shows up first, because Egypt has two of these sites under construction with the same contractor and the same civil works subcontractor.

AnalysisOman

Oman's first wind turbine factory signs a university to train about 321 Omani graduates

Mawarid Turbine and the National University of Science and Technology agreed in February to train graduates in blade manufacturing and nacelle assembly for the Duqm plant.
1 min read

Oman’s first wind turbine factory has a Chinese EPC contractor and a Chinese technology licensor. The part it went to a university for was people.

On 4 February this year, Mawarid Turbine Company and the National University of Science and Technology signed a cooperation agreement to qualify approximately 321 Omani graduates for the plant being built in the Special Economic Zone at Duqm. Oman News Agency described the group as the first national batch to receive specialised industrial training in wind turbine manufacturing. Mustafa bin Mohammed al Hinai, CEO of Mawarid Turbine, and Dr Ali bin Saud al Bimani, the university’s Vice-Chancellor, signed it. Dr Abeer bint Ali al Kalbani, who directs national competency development and local content at Mawarid Turbine, said the programme would start that same month and would concentrate on blade manufacturing and the assembly of nacelle units. I have not found a published account of where that cohort stands today, so read this as February’s plan rather than this month’s result.

Four months later, on 10 June, the Oman subsidiary of China Energy Engineering Corporation’s Shanxi institute took the EPC contract for roughly 90,000 square metres of workshops and supporting facilities at Duqm. Shanghai Electric Wind Power holds the technology licence and the knowledge-transfer role, which includes sending Omani engineers and technicians to China for training.

What I keep coming back to is the sourcing pattern. The plant is Omani-owned, Chinese-built and Chinese-licensed. The workforce is the one input Oman went to a domestic university to secure.

In my reading, most localisation targets in this region are written as percentages and gigawatts. My view is that blade layup and nacelle assembly are hand skills that take years to become reliable, and 321 is a number you can count.

Who is running the second batch?

AnalysisMENA

Masdar's 2 GW Bahrain wind deal cites three credentials that read as a near-shore specification

In May 2024 Masdar and Bapco Energies agreed to explore up to 2 GW of near-shore and offshore wind in Bahrain, citing London Array, Dumat Al Jandal and the UAE Wind Program.
1 min read

Masdar listed three of its own wind projects as credentials in the Bahrain announcement. Read together, they are a specification.

In May 2024 Masdar signed an agreement with Bapco Energies to jointly explore the development of and investment in wind projects in Bahrain with a capacity of up to 2 GW. The agreement covers near-shore and offshore wind farms. Masdar’s release called it Masdar’s first agreement in the Kingdom and the first project of its kind in the region and the Middle East. Mark Thomas, Bapco Energies Group Chief Executive Officer, called it a bold step towards the ambitions set out in Bahrain’s National Energy Strategy, which targets a 30 percent emissions cut by 2035 and net zero by 2060.

Now read the three reference projects Masdar put in the same release.

The 630 MW London Array in the UK, which powers half a million British homes. That is the offshore build.

The 400 MW Dumat Al Jandal in Saudi Arabia. That is the regional onshore build.

The 103.5 MW UAE Wind Program, which in Masdar’s own words uses technology to capture low wind speeds at utility scale. That is the resource problem.

Three competencies, in three separate places. What I keep coming back to is that a near-shore Gulf wind farm would be the first job asking all three to work at once: marine construction, regional operating conditions, and machines that earn a return in slow air. Bahrain’s entry point is water.

Two gigawatts of exploration is a headline. A low-wind-speed turbine turning in salt water is an engineering brief.

That agreement was signed more than two years ago and I make no claim about where it stands today. The question I would put to the room is narrower. When a Gulf state does go offshore, does it import the North Sea playbook or write its own?

AnalysisSyria

Syria's 700 MW wind deal with Marv Energy plans 140 turbines from one factory in Homs

Syria's Ministry of Energy signed with Marv Energy in February. The company says production will take place at its Homs plant, in phases, over five to seven years.
1 min read

Seven hundred megawatts. One hundred and forty turbines. One factory in Homs that has to build them.

In February, Syria’s Ministry of Energy signed a wind power agreement with Marv Energy at the ministry’s headquarters in Damascus. Energy Minister Mohammad Al-Bashir signed for the government, board member Valerina Elias for the company. Deputy Minister for Electricity Affairs Omar Shaqrouq said the 700 MW will feed the national grid rather than any single province, and that turbine sites will be chosen on measured wind speeds across the country. No locations have been named. Elias said production will take place at the company’s plant in Homs, in phases, over five to seven years, and called the project a “proof stage” for Syrian industry.

Do the division. 700 MW across 140 machines gives 5 MW per turbine, a mainstream onshore size today. Spread over five to seven years, the build rate sits somewhere between 100 and 140 MW a year. For scale, the same ministry signed in November for eight power plants totalling 5,000 MW.

Hold that annual rate against the regional one. GWEC’s latest report puts Africa and Middle East additions at 2.6 GW in 2025, up 32%, with Saudi Arabia taking 1,512 MW of that on its own. Cumulative installed capacity across the region reached 15.2 GW.

What I keep returning to is the order of operations. Saudi Arabia and Oman are building turbine plants into markets that already carry order books, and GWEC counts those announced manufacturing investments among the things that could take the Middle East past 18 GW of new onshore wind by 2030. The Homs plan puts the factory first and asks a phased build to keep it running.

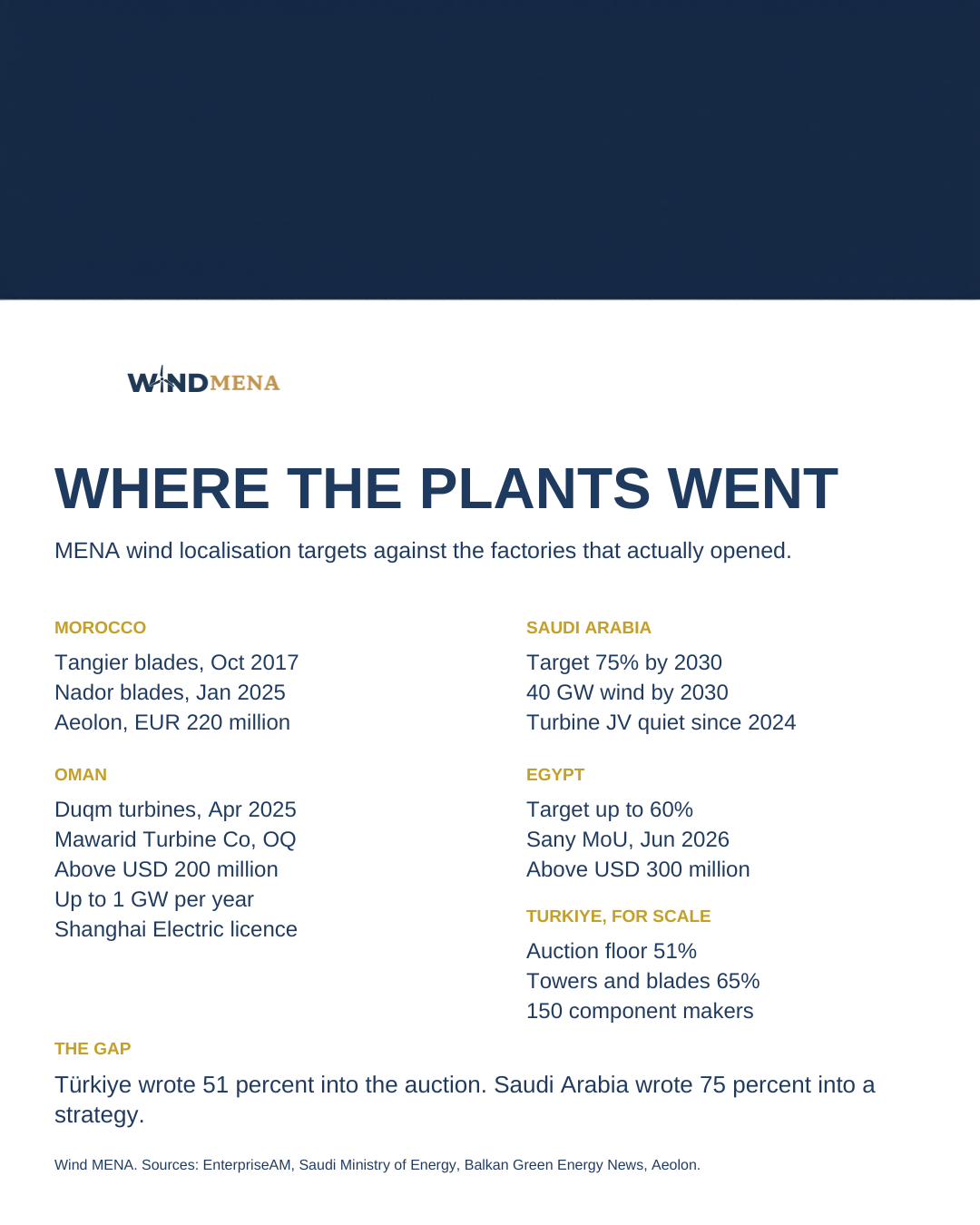

Localisation in this region has generally followed demand. Can it lead it?

AnalysisOman

Oman's 125 MW Dhofar II wind farm will free about 76 million cubic metres of gas a year

Nama PWP's CEO put the gas figure beside 396,754 MWh of annual output. Oman shipped 11.9 million tonnes of LNG in 2025, above its 10.4 Mtpa liquefaction capacity.
1 min read

Nama Power and Water Procurement’s chief executive gave a number at the Dhofar II signing that I have rarely seen repeated. The wind farm will free up around 76 million cubic metres of natural gas a year.

The rest of the project reads normally. Dhofar II is 125 MW, twenty Windey WD200 turbines at 6.25 MW each, 215 metres to the tip, built and owned by Sembcorp and OQ Alternative Energy under a 20-year power purchase agreement, commercial operation targeted for the third quarter of 2027. Annual generation of roughly 396,754 megawatt-hours. Ahmed bin Salim Al Abri put the gas figure beside it in the same statement.

Divide one by the other. Every megawatt-hour Dhofar II makes hands Oman back about 192 cubic metres of gas. Read backwards, my arithmetic puts that close to what a combined-cycle plant burns to produce the same unit.

Then look at where Omani gas goes. The country shipped 11.9 million tonnes of LNG in 2025, eighth largest exporter in the world at 2.7% of global trade, against installed liquefaction capacity of 10.4 million tonnes a year. The International Gas Union put Oman above nominal capacity for the year. My read is that feedstock, more than nameplate, is what limits those trains.

I read Dhofar II’s contract as paying Oman twice. Nama PWP buys electricity at a tariff. The state collects molecules back, in a system whose export plants ran past their nameplate last year.

We keep judging Gulf wind tariffs against the domestic cost of gas. What does the same tariff look like priced against the export gate?
